A Deal That Started in 2011
The story begins in September 2011, when Pasco County commissioners unanimously approved a sweeping incentive package to bring Raymond James Financial—the St. Petersburg-based financial services giant—to the Wiregrass Ranch area. The deal was worth roughly $15 million in combined county and state incentives, including tax breaks, fee waivers, and funding for road improvements along what would become Wiregrass Ranch Boulevard.
In return, Raymond James committed to building a satellite office campus on 65 acres at the corner of State Road 56 and Mansfield Boulevard, just east of the Shops at Wiregrass. The original plan called for two 100,000-square-foot office towers, with construction tentatively set to begin as early as 2012. The first building was expected to open by 2013, and the company pledged to create 750 jobs in Pasco County by 2024—with the first 100 arriving by 2014.
At the time, local leaders called it a transformative moment. According to a Pasco Economic Development Council analysis, the project was projected to generate $40 million in local property tax revenue and $135 million in taxable sales over its first 17 years. The broader economic ripple effect was estimated at 1,200 direct and indirect jobs with total payroll reaching $600 million.
Key Facts
First announced: September 2011
Location: 65 acres at State Road 56 & Mansfield Boulevard, east of the Shops at Wiregrass
Original incentive package: ~$15 million (county and state combined)
Promised jobs: 750 by 2024
Planned office space: Up to 1 million square feet
Current status: No vertical construction has begun
Years of Delays Before the Land Was Even Purchased
Despite the optimistic projections, the project stalled almost immediately. Raymond James signed a letter of intent with the Porter family—the longtime owners and developers of Wiregrass Ranch—but the actual land purchase did not close for another five years.
By 2013, Pasco County had approved an expanded concept: six four-story buildings totaling up to one million square feet of office space, plus a parking garage. But there was no groundbreaking, no construction timeline, and no dirt moving on the site.
In October 2014, Raymond James CEO Paul Reilly publicly acknowledged the delays. According to reporting at the time, Reilly told media that while the company still intended to close on the Pasco land, it was pushing the timeline back by as much as five years. The company simply did not need the space yet. That news landed especially hard coming just months after another major corporate prospect, T. Rowe Price, pulled out of a separate Pasco County deal entirely.
In early 2016, Wiregrass Ranch developer J.D. Porter addressed community skepticism head-on at a public meeting, reassuring residents that Raymond James would follow through on the land purchase.
The Land Sale Finally Closes—With a Catch
In September 2016—a full five years after the original announcement—Raymond James finally closed on the 65-acre site. According to publicly available property records and reports at the time, the Porter family sold the land at approximately $26,153 per acre, totaling roughly $1.7 million. That price was well below market value for the area, a deliberate move to entice the company to commit to Pasco County.
There was a notable detail in the closing, however. Just two days before the sale was finalized, Pasco County amended its incentive agreement with Raymond James and Wiregrass Ranch Inc. to remove any deadline requiring construction to begin by a certain date. That amendment gave the company effectively unlimited time to develop the property.
Even after purchasing the land, Raymond James remained noncommittal about when actual building would start. The company acknowledged the site as a long-term asset but made no promises about a construction schedule.
Why This Matters to Wesley Chapel
The Raymond James campus was supposed to be a cornerstone of Wesley Chapel’s transition from a bedroom community to a regional employment hub. Without it, thousands of Pasco residents continue commuting south to Hillsborough County for work. Every year the project remains idle, the area misses out on hundreds of high-wage jobs and millions in potential tax revenue.
A Brief Burst of Momentum in 2019

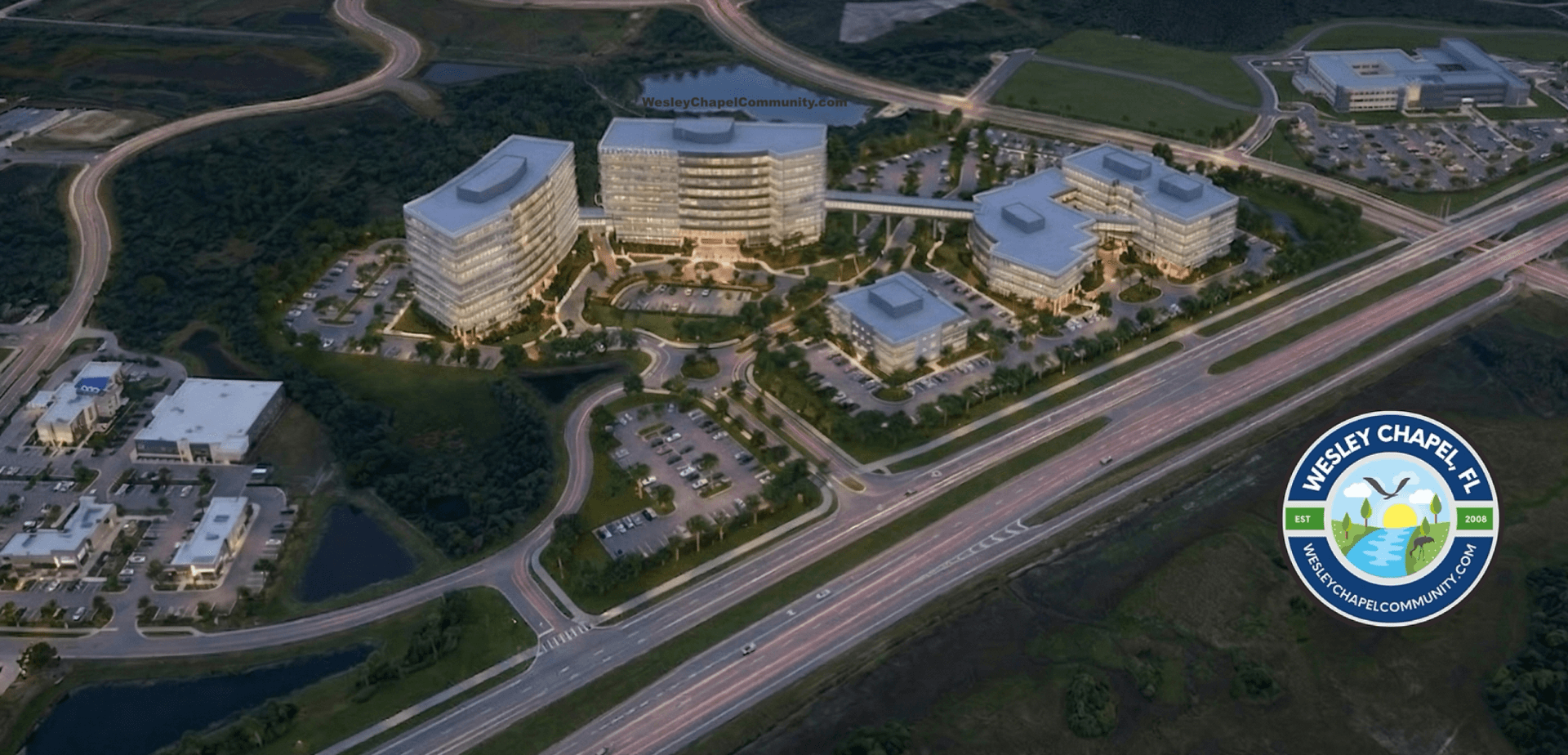

The project appeared to gain real traction in late 2019 when Raymond James filed a preliminary site plan with Pasco County and requested a meeting with county planners. The updated plans showed five office buildings and two parking garages spread across the 65-acre site. The scope had changed from the original two-tower concept but still envisioned a major corporate presence along State Road 56.
According to reports at the time, Pasco County Commissioner Mike Moore expressed enthusiasm, suggesting that site work could begin within weeks. The Pasco Economic Development Council also reaffirmed its support for the project.
Then came 2020, and the pandemic reshaped how companies thought about office space nationwide. No further public progress was reported.
Where Things Stand Now
In a May 2023 interview, Wiregrass Ranch developer J.D. Porter offered what has been the most recent substantive update on the campus. According to Porter, Raymond James had invested several million dollars in preliminary site work on the property. He indicated that the company could potentially begin vertical construction—meaning actual buildings going up—within months.
That target came and went without visible construction activity on the site.
Meanwhile, Raymond James has continued expanding at its home base. The company acquired additional buildings at its Carillon Office Park campus in St. Petersburg, growing its footprint there to approximately 1.2 million square feet. CEO Paul Reilly has acknowledged publicly that the company obtained a second operations center in Memphis, Tennessee, through its acquisition of brokerage firm Morgan Keegan, which reduced the urgency for the Pasco location.
According to publicly available information, Raymond James has described the Wiregrass Ranch property as a long-term growth opportunity, citing the area’s access to a different employee base and favorable commute geography. However, the company has not committed to a firm construction date or disclosed definitive development plans for the site.
15 Years
Since original announcement
65 Acres
Purchased in 2016
0
Buildings constructed
~$15M
In public incentives committed
A Timeline of Missed Targets
For Wesley Chapel residents who have been following this saga, the pattern has become familiar. Here is a condensed look at the major milestones and missed deadlines:
YearEvent2011Project announced; incentive package approved; construction targeted for 20122013Expanded plans approved (six buildings, 1 million sq. ft.); no construction begins2014CEO Reilly confirms delays of up to five years; T. Rowe Price also exits Pasco2016Environmental permit issued; land purchase closes; construction deadline removed from incentive agreement2017Construction expected “later this year”—does not materialize2019Preliminary site plan filed with Pasco County showing five buildings2020Pandemic shifts national office demand; no visible progress2023Developer says vertical construction could start by mid-year; it does not2026No buildings have been constructed on the site
What Comes Next?
There is no confirmed timeline for when—or whether—Raymond James will break ground on the Wesley Chapel campus. The company still owns the 65-acre parcel, and there has been no indication that it plans to sell the land or abandon the concept entirely. But neither has there been a public commitment to a construction start date.
The broader Wiregrass Ranch area has continued to develop rapidly around the vacant site. The Shops at Wiregrass, Pasco-Hernando State College’s Porter Campus, AdventHealth Wesley Chapel, the Wiregrass Ranch Sports Campus, and a growing roster of medical, retail, and residential projects have transformed the surrounding landscape. A new Orlando Health hospital in the Wiregrass area is also underway.
For many residents, the Raymond James campus has become both a symbol of Wesley Chapel’s ambitions and a frustrating reminder of how long major economic development can take. Whether the company ultimately builds the office complex it envisioned more than a decade ago—or the site evolves into something different—remains one of the most closely watched open questions in the community.
No additional details were immediately available from Raymond James or Pasco County officials at the time of publication.
